​​​​​​​More shipping capacity through new compressor station

Gas travels thousands of kilometres in international and national pipelines before reaching consumers. Thanks to compressor stations, gas is compressed and its pressure increased. This means that more gas can be transported through the pipeline. The shipping capacity of the pipeline increases – and therefore also the security of supply.

Our new gas compressor station on the Nordschwarzwald pipeline is being built in Rheinstetten in the Hardtwald south of the radio mast between the L566, the B3 and the A5. Construction began in the autumn of 2021. Commissioning is planned for 2023/2024.

Data and facts

Current timeline

September 2021

terranets bw begins building the gas compressor station

August 2021

Freiburg Regional Council grants terranets bw approval for building the gas compressor station on the Nordschwarzwald pipeline Pressemitteilung des RP Freiburg

02.07.2021

Information meeting within the scope of the online consultation (Freiburg Regional Council)

05.02.2021 to 04.03.2021

Application documents on display at Freiburg Regional Council, Rheinstetten town, Ettlingen town and in the community of Durmersheim and are available for viewing online on the internet homepage of Freiburg Rergional Council.

06.07.2020

Information market "Gas Compressor Station on the Nordschwarzwald Pipeline", Ufgauhalle Rheinstetten
invitation

Current information

After receiving approval, building began in the autumn of 2021.
We keep you informed. Here, you can always find information on the current status of construction works as well as pictures of the construction site.

Subscribe for current information

Construction phases of the gas compressor station

[Translate to English:] Gasverdichterstation an der Nordschwarzwaldleitung: Tag der offenen Baustelle
[Translate to English:] Gasverdichterstation an der Nordschwarzwaldleitung: Tag der offenen Baustelle
[Translate to English:] Gasverdichterstation an der Nordschwarzwaldleitung: Tag der offenen Baustelle

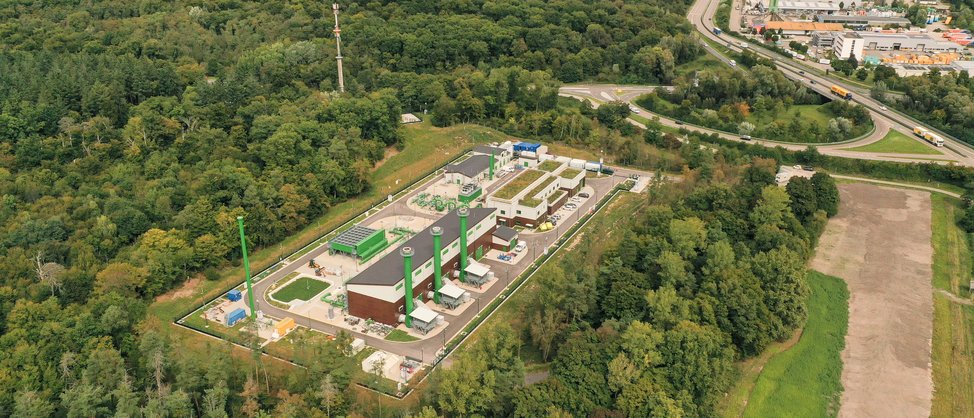

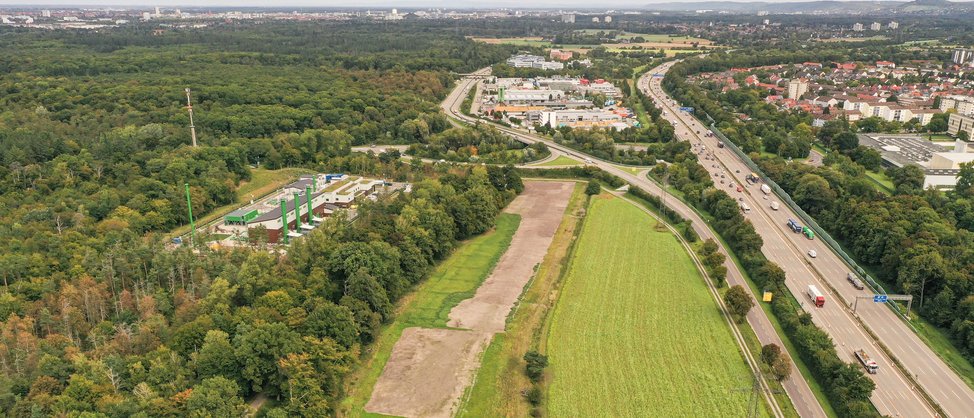

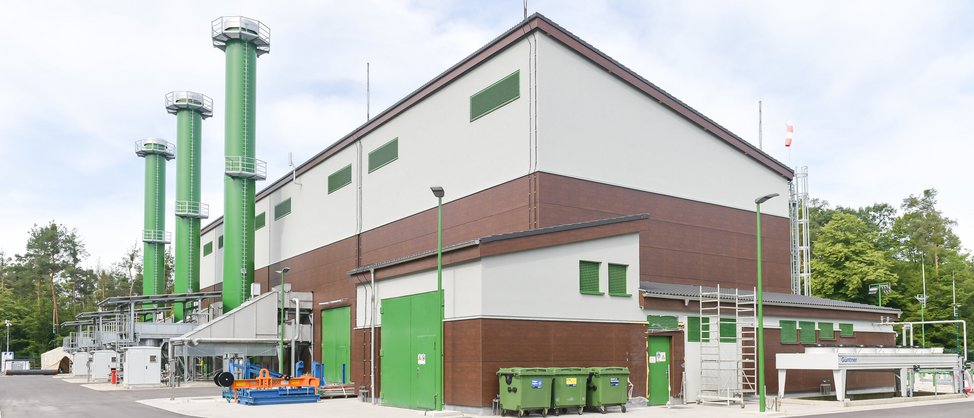

September 2023: Tag der offenen Baustelle

Am 23. September ermöglichte terranets bw im Rahmen der Energiewendetage Baden-Württemberg allen Interessierten einen Einblick in den Bau der Gasverdichterstation. Bei einem geführten Rundgang erklärten Expert:innen die Funktionsweise einer Gasverdichterstation. An verschiedenen Stationen konnten die Besucher:innen zudem erfahren, welche Maßnahmen zum Schutz der Umwelt umgesetzt werden. So wird die Anlage zum Beispiel mit einer insektenfreundlichen Beleuchtung umgesetzt.

Zum Ausgleich für unvermeidbare Eingriffe werden unter anderem Waldgebiete aufgeforstet. Auch die Zukunft der Energieversorgung mit Wasserstoff war für die Besucher:innen von großem Interesse. terranets bw arbeitet an der Anbindung Baden-Württembergs an die europäische und nationale Wasserstoffinfrastruktur und bereitet sein Netz auf den Transport von Wasserstoff vor.

August 2023: Aufsichtsratsvorsitzender besucht Baustelle

Dirk Güsewell, Vorsitzender des Aufsichtsrates der terranets bw GmbH und Mitglied des Vorstands der EnBW Energie Baden-Württemberg AG, nutzte am 9. August die Gelegenheit zu einer Besichtigung der Baustelle der Gasverdichterstation Nordschwarzwaldleitung in Rheinstetten. In Begleitung von Geschäftsführerin Katrin Flinspach und Dr. Daniel Pietzka (Bereichsleitung P) informierte er sich über den aktuellen Stand der Bauarbeiten. Projektleiterin Susanne Kurschat (P) und Wolf Künzelmann (Oberbauleitung) führten ihre Gäste über die Baustelle.

Am Wochenende zuvor fand die Dichtheitsprüfung der gesamten Gasanlage statt. Diese wurde erfolgreich absolviert.

Schon bald erhalten alle Interessierten die Möglichkeit, am 23. September von 14 bis 17 Uhr bei einem "Tag der offenen Baustelle", der im Rahmen der "Energiewendetage Baden-Württemberg" stattfindet, die Baustelle selbst zu besichtigen. Die Anmeldung zu den Führungen ist voraussichtlich ab dem 4. September hier auf der Projektwebsite möglich.

Juli 2023: Innenausbau und Elektroinstallation schreitet voran

Die letzten Monate und Wochen standen im Zeichen des Innenausbaus. Der aktuelle Fokus liegt auf der Elektroinstallation und der technischen Gebäudeausrüstung. Die ersten Schaltschränke in allen Gebäuden wurden angeliefert. Im Betriebsgebäude sind alle Türen und Fenster montiert. Zudem hat die Installation der Sanitäranlagen begonnen. In der Maschinenhalle wird bereits mit der Verkabelung der Verdichtereinheiten begonnen.

Auch viele Nebenanlagen wir Rückverdichter, Harmonische Filter und die Mittelspannungsanlage befinden sich in der Montage. Auf dem gesamten Gelände nimmt die Auffüllung des Geländes weiter Form an. Am Ende wird das Gelände ca. zwei Meter über der ursprünglichen Geländeoberkante liegen.

Auch wenn die Verdichterstation von außen inzwischen ihre endgültige Form annimmt, bleibt weiterhin viel zu tun: Es müssen noch rund 130 km Kabel verlegt, mehr als 10.000 Kabeladern angeschlossen und 660 Sensoren und Aktoren in der Anlage montiert werden. Anfang August findet zudem eine Druckprüfung für alle Rohrleitungen auf dem Gelände statt.

Save the Date: Am 23. September organisiert terranets bw im Rahmen der "Energiewendetage Baden-Württemberg" einen "Tag der offenen Baustelle". Nähere Informationen zur Veranstaltung folgen in den nächsten Wochen.


April 2023: Pressure test successfully carried out; integration of the valve group into the Nordschwarzwald pipeline completed
April 2023: Pressure test successfully carried out; integration of the valve group into the Nordschwarzwald pipeline completed
April 2023: Pressure test successfully carried out; integration of the valve group into the Nordschwarzwald pipeline completed

April 2023: Pressure test successfully carried out; integration of the valve group into the Nordschwarzwald pipeline completed

In March, a pressure test of the fittings group and fuel gas pipeline was successfully carried out.
The construction of the new valve group as a link between the Nordschwarzwald pipeline and the gas compressor station is almost complete.

The connection of the fittings group to the existing Nordschwarzwald gas pipeline (NOS) of terranets bw was successfully completed at the beginning of April.The connecting pipeline from the fittings group to the compressor station has also already been laid. The connection is scheduled for April 2023.

In the past few weeks, the roof work on the operations building and the energy centre was completed. The interior work is progressing; floors, doors and stairs are being installed and painting work is being carried out.

In the coming weeks, the interior work on the operations and workshop building and the energy centre will continue at full speed. The pipe construction of the compressor station should essentially be completed by summer.

February 2023: Interior works in the buildings start, pipe construction for integrating into the Nordschwarzwald pipeline progresses

February 2023: Interior works in the buildings start, pipe construction for integrating into the Nordschwarzwald pipeline progresses

After a short winter break, construction works for the gas compressor station in Rheinstetten were resumed at the beginning of the year. The facade works on the machine hall progress. The roof work on the operations building and the energy centre is expected to be finished in March, at the same time interior works begin. In February, the last pipe material for the pipe construction was produced and will now be delivered step by step to the construction site.

Welding work has now started on site to construct the connection line to the Nordschwarzwald pipeline (NOS) as well as for the fuel gas pipeline. Welding of the fittings group has almost been completed. Integration of the gas compressor station into the NOS is expected to occur in April. At the same time, reforestation of woodland areas in Rheinstetten begins with the planting of oak trees and robust shrubs in February. These measures were defined as ecological compensation measures for the construction of the station.

December 2022: Delivery of the electric compressor, integration into the Nordschwarzwald pipeline is prepared, first compensation measures have begun

With completion of the four compressor halls, they are now ready for installing the compressor units. In December, two of the three gas compressors as well as the electric compressor were already delivered. The turbines for the compressor units have already been delivered and the last compressor will be delivered in January 2023. Parallel to this, construction works on the operations building and energy centre are progressing: the first floor of the operations building has been completed, structural works for the energy centre will be finished in January 2023.

The civil works for the fittings group as well as the connection lines to the Nordschwarzwald pipeline (NOS) have also been completed. The pipes are ready for the pipe construction, which will begin at the beginning of next year. Foundations for the piping of the compressor station were also poured. Simultaneously, the first ecological compensation measures for the construction of the gas compressor station were initiated.

[Translate to English:] November 2022: Verdichterhallen, Filteranlagen und Gaskühler sind errichtet
[Translate to English:] November 2022: Verdichterhallen, Filteranlagen und Gaskühler sind errichtet
[Translate to English:] November 2022: Verdichterhallen, Filteranlagen und Gaskühler sind errichtet
[Translate to English:] November 2022: Verdichterhallen, Filteranlagen und Gaskühler sind errichtet

November 2022: Compressor halls, filter systems and gas coolers are erected, integration into the Nordschwarzwald pipeline is prepared

All four halls are erected where the compressor units will be installed in the next months. Construction of the operations building, in which both the repair shop and the offices for terranets bw employees will be located, has made great progress. This means that the landfill of the site to reduce the incline to the Panzer street could begin.

In addition, integration of the gas compressor station into the existing Nordschwarzwald gas pipeline (NOS) is prepared. The civil works of the fittings group required for this will be completed by the end of the year. Parallel to this, connection lines to the NOS are being built. The filtersystems through which the gas is cleaned prior to the compression process have already been assembled and the gas coolers that will cool down the gas to transport temperature after compression have also been installed in the meantime.

[Translate to English:] September 2022: Tag der offenen Baustelle
[Translate to English:] September 2022: Tag der offenen Baustelle
[Translate to English:] September 2022: Tag der offenen Baustelle
[Translate to English:] Anlieferung Turbine erste Verdichtereinheit

September 2022: Construction site opening day, delivery of turbine for the first compressor unit

On 24 September, as part of the Baden-Württemberg Energy Transition Days, terranets bw enabled all interested parties to gain an insight into the construction of the gas compressor station. At different stations, visitors could learn about the construction, function and importance of the gas compressor station for the energy transition

In addition , experts were available to answer questions and exchange information on the project at information boards as well as at vantage points over the construction site. At the end of September, theturbine was delivered that forms part of the first compressor unit.

To the press release

[Translate to English:] Oberbürgermeister der Stadt Rheinstetten besucht Baustelle
[Translate to English:] Oberbürgermeister der Stadt Rheinstetten besucht Baustelle

August 2022: Mayor of the City of Rheinstetten visits construction site

In the middle of August, Sebastian Schrempp, Mayor of the City of Rheinstetten, visited the construction site and together with Managing Director Katrin Flinspach, the Technical Project Leader Nils Höger and the Commercial Project Leader Susanne Kurschat, was able to gain an impression of the construction progress on site.

In August, the gas cooler is installed as planned and in the meantime, great progress has also been made on the interior works in the compressor halls. Installation of the first compressor unit begins in autumn and by the end of the year, the remaining three compressor units will be installed. With the erection of the operations building and the energy centre, structural works for all buildings are also to be completed by the end of the year.

[Translate to English:] Gasverdichterstation Rheinstetten: Drei Verdichterhallen sind errichtet
[Translate to English:] Gasverdichterstation Rheinstetten: Drei Verdichterhallen sind errichtet
[Translate to English:] Gasverdichterstation Rheinstetten: Drei Verdichterhallen sind errichtet

July 2022: Three compressor stations are built; inlet pipe is being prepared

Structural building work of three of the four planned compressor halls has been completed. The fourth compressor hall is expected to be finished at the end of the year. Finishing works in the halls have also begun in the meantime along with preparations for installing the machines.

The compressor units will be delivered and assembled by autumn 2022. Additionally, work has started on the station piping together with preparations for fitting the gas cooler in August 2022.

May 2022:Construction of the machine hall has begun
May 2022:Construction of the machine hall has begun
May 2022:Construction of the machine hall has begun

May 2022: Building construction of the machine hall has begun

Now that foundation work for the machine hall and the operation building have been completedstructural work for the machine hall has begun. After fitting the ground slab, the columns for the hall have been erected. After that the wall elements, delivered as prefabricated parts, will be installed.



Commercial Project Manager, Susanne Kurschat, and Technical Project Manager, Nils Höger, inform themselves weekly about the progress of the construction measures with an on-site inspection.

Gas compressor station on the Nordschwarzwald pipeline Vorbereitung der Fundamente
Gas compressor station on the Nordschwarzwald pipeline
Gas compressor station on the Nordschwarzwald pipeline

January 2022: the setting up of the construction site completed, preparation of the foundations

Construction works for the new gas compressor station in Rheinstetten are progressing. Recently, setting up of the construction site was completed. This means all storage, handling and traffic areas are prepared. Equipment, machines and containers for the workers as well as for weather-sensitive building materials are also ready. terranets bw´s technical project manager, Nils Höger, who is regularly on site, also has a permanent working place on the construction site. In these weeks, foundations for the planned buildings such as the machine hall, the energy centre and the administration building are being prepared.

For this purpose, the previously braided rebars are filled with concrete. The surrounding formwork ensures that the concrete can harden without any negative external impact.
In the next step, the ground slabs are also made of reinforced concrete and will later support the prefabricated walls. And what is indispensable in all this: both 25-metre-high construction cranes used for construction site logistics.

27 October 2021: ground-breaking ceremony
27 October 2021: ground-breaking ceremony
27 October 2021: ground-breaking ceremony

27 October 2021: groundbreaking ceremony

The groundbreaking ceremony on 27 October 2021 signalled commencement of construction works for the gas compressor station in Rheinstetten. The event was opened by Katrin Flinspach, Managing Director of terranets bw GmbH. Subsequently, Sebastian Schrempp, Lord Mayor of Rheinstetten and Dirk Güsewell, Chairman of the Supervisory Board of terranets bw and member of the Executive Board of Energie Baden-Württemberg AG (EnBW) addressed the guests.

About 50 guests accepted the invitation to Rheinstetten, including representatives of Rheinstetten municipal council, project partners as well as terranets bw employees.

To the press release

October 2021: groundbreaking ceremony
Beginning of September 2021: construction works start
Beginning of September 2021: construction works start
Beginning of September 2021: construction works start

Beginning of September 2021: construction works start

On 6 September, initial construction works began on site. This included setting up the construction site area and erecting a construction sign.

From 13 September, the site was prepared for the new gas compressor station.

While preparing for the construction works, measures were implemented to protect nature around the site and to work on compensation for the impact. Since the commencement of construction, interested parties have been able to discover more about the project, the single project steps and the measures implemented to protect the environment during construction and operation of the gas compressor station.

Questions and answers

  • What is a gas compressor station?

    What is a gas compressor station?

    In a gas compressor station, gas is compressed and its pressure increased. This means more gas can be transported through the pipeline. The shipping capacity of the pipeline increases – and therefore also security of supply for consumers. In Germany, there are about 70 gas compressor stations that are operated in particular in the case of increased capacity demand – which is primarily in winter time.

  • How does a gas compressor station work?

    How does a gas compressor station work?

    Travelling through underground pipelines, gas reaches the compressor station with a pressure of 40 bar. Firstly, dust and moisture are filtered out. And then the gas is passed into the compressor and there brought to the required pressure. A turbine or electric engine supplies the energy needed for the compression process.
    During compression, the gas heats up to 70 °C and is therefore fed through gas coolers that cool it back down to operating temperature. The gas is then fed through a measuring section before being injected back into the transmission system of terranets bw with a pressure of 80 bar.

  • Why is a gas compressor station needed on the Nordschwarzwald pipeline?

    Why is a gas compressor station needed on the Nordschwarzwald pipeline?

    Regional grid operators connected to terranets bw´s transmission system (e. g. utilities) have been reporting constantly increasing demand for gas shipping capacity for years. By 2030, the demand in Baden-Württemberg will rise by about 30 % compared to 2020. For the entire terranets bw network, a demand increase of 24 percent is expected. The reason for this trend is the fuel switch from coal and oil to gas, the related rising demand from gas-fired power stations and in the heating market as well as new connections and developments.

    The Federal Network Agency has confirmed the need for building the gas compressor station to secure supply in Baden-Württemberg by confirming the Gas Network Development Plan 2020-2030 in May 2021. All Network Development Plans are published on the website of the association of transmission system operators at www.fnb-gas.de.

  • How was the location for the gas compressor station selected?

    How was the location for the gas compressor station selected?

    Site selection was preceded by detailed studies, in which terranets bw took into account legal stipulations and technical requirements as well as a wide range of influencing factors. These include protected areas, distances to residential buildings, land use plans and information provided by the communities. After intensive assessment and in close exchange with local authorities and associations, a location was selected for the new compressor station. Special consideration was also given to maintaining a low visibility of the system. During the approval process, the Freiburg Regional Council, as competent approval authority, decided that the station could be built and operated at the proposed site.

  • What will the gas compressor station on the Nordschwarzwald pipeline look like?

    What will the gas compressor station on the Nordschwarzwald pipeline look like?

    A photomontage shows what the gas compressor station at the Rheinstetten site could look like. Here you can see the machine hall, which will house four machine units consisiting of a compressor and an engine. Next to it, there will be an administration building. (cf. How does a compressor station work?)

  • Who approves construction and operation of a gas compressor station?

    Who approves construction and operation of a gas compressor station?

    Construction and operation of gas compressor station requires public-law permission according to the Federal Immission Control Act (German: BImSchG). The competent approval authority is the Freiburg Regional Council. In order to achieve broad consensus with all stakeholders, terranets bw involved the affected communities and other stakeholders at an early stage.

  • Who is responsible for building the gas compressor station?

    Who is responsible for building the gas compressor station?

    Transmission system operators in Germany are obliged to guarantee a future-proof supply of gas by developing their network. As an independent transmission system operator for gas in Baden-Württemberg, terranets bw is responsible for building the gas compressor station.

  • How much space does a gas compressor station need?

    How much space does a gas compressor station need?

    When operational, the planned gas compressor station needs an area of approx. 2.4 ha (24,000 m²). This is roughly equivalent to the size of three football fields. During construction, additional land is temporarily needed for setting up the construction site and for the storage of building equipment and material.

  • What restrictions can be expected during the construction phase?

    What restrictions can be expected during the construction phase?

    For construction, additional areas are temporarily occupied for setting up the construction site and for the storage of building equipment and materials.

    An increased volume of traffic can be expected because of deliveries along the access roads. As soon as the building works have been completed, the areas that were temporarily occupied (for setting up construction site and storing building equipment and material as well as the access roads) will be restored to their original state and can be used for their original purpose once again. Damage to land and vegetation caused by this temporary use will be compensated at the fixed rates.

  • Is noise pollution expected near the gas compressor station?

    Is noise pollution expected near the gas compressor station?

    When operating a gas compressor station, the noise pollution at the fence of the system corresponds to about 60 dB(A). This is comparable to a television set at room volume. The noise pollution at a distance of 350 m is then about 35 dB(A). This complies with statutory limits for a quiet residential area. The distance between the planned gas compressor station and the nearest residential area will be more than 350 m. Generally, the local noise situation is largely influenced by the neighbouring roads (A5, L566, K3581).

    During the planning process, expert opinions are prepared regarding the noise emissions that can be expected. The results of these expert opinions serve to determine and dimension the noise protection measures required to comply with the statutory noise protection limits.

  • Who checks the safety of the gas compressor station?

    Who checks the safety of the gas compressor station?

    Operation and maintenance are carried out by qualified specialists employed by terranets bw. The gas compressor station is monitored and controlled, as is the whole transmission system of terranets bw, by a dispatching centre that is manned 24/7.

    Compliance with legal and technical regulations is monitored by the state energy supervisory authority. Modifications must be inspected and signed-off by state certified experts. The supervisory authority for terranets bw is the State Mining Directorate (German: Landesbergdirektion) of the Freiburg Regional Council.

  • How long will it take to construct the gas compressor station?

    How long will it take to construct the gas compressor station?

    Constructing and commissioning a gas compressor station normally take about two years. This period includes land development, erecting the buildings, installing the compression equipment as well as restoring open spaces on the station site.

    Construction began in the autumn of 2021 after receiving approval. Commissioning is planned for 2023/2024.

  • How does terranets bw guarantee that the surroundings and environment are protected during construction?

    How does terranets bw guarantee that the surroundings and environment are protected during construction?

    Throughout the whole planning and construction process, terranets bw takes numerous precautions to minimise the impact on nature and on the environment. At the start of the planning phase, terranets bw takes a detailed inventory of the landscape and surrounding nature and assesses the impact on plants, animals, ground, water, climate/air, landscape and people as well as on cultural assets.

    Measures were derived from the study results to avoid and reduce the impact on the environment, which meant that the compressor station location, access and gas connection pipeline were adapted to avoid disruption of the forest edge as far as possible. The edge of the forest serves as a guiding structure for bats and additionally acts as a natural screen for the gas compressor station. Permanent lighting at the gas compressor station will also be avoided and insect-friendly lighting will be used. Measures to protect reptiles and amphibians will be implemented during the construction phase.

    Unavoidable, permanent impairments will be compensated by corresponding measures (compensation measures). In addition to planting new trees, nesting boxes and hatching aids for birds and bats are planned for example, as well as upgrading a humid biotope in Rheinstetten.

  • What emissions are produced in operation?

    What emissions are produced in operation?

    Derived from empirical values for operating times at the terranets bw compressor stations, weather conditions over the last few years and the planned control of the network after commissioning the new compressor station, terranets bw currently estimates 500 to 2,000 operating hours per year. This assumption includes the sum of operating hours for all machine units (three gas turbines, one electric engine). The local CO2 emissions of one machine unit operated with a gas turbine amount to about 4,000 kg per operating hour. By using the electrically-powered machine unit, the local CO2 emissions are reduced.  The level of CO2 emissions depends on the respective distribution of electricity generation. Using only machine units that are powered by a gas turbine produces 2,000 t to 8.000 t of local CO2 emissions per year.

    terranets bw also uses a recompressor system at the gas compressor station in Rheinstetten. This is an additional measure taken by terranets bw to avoid methane emissions when operating the system.
    Small amounts of methane escape at the drive shafts of the compressor units, which cannot be avoided completely. However, this methane is collected in a collection system and injected back into the transmission system with the recompression system. All other components of the compression system are technically sealed so that no methane emissions can escape.

Downloads

Here you will find all relevant information and downloads related to the gas compressor station on the Nordschwarzwald pipeline.

Please contact us

We are happy to help you.

Susanne Kurschat

Susanne Kurschat

Commercial Project Management
Compressor Station Nordschwarzwald Pipeline

s.kurschat@terranets-bw.de
+49 711 7812 1257

Contact now

Rebecca Penno

Rebecca Penno

Head of Corporate Communications

presse@terranets-bw.de
+49 711 7812 1266

Contact now

Nils Höger

Nils Höger

Technical Project Management
Compressor Station Nordschwarzwald Pipeline

n.hoeger@terranets-bw.de
+49 711 7812 1283

Contact now

Cookie-Einstellungen
